Budget overruns, permit delays, and layout mistakes turn a dream café into a stressful cash drain. Get the planning right, and you avoid most of that.
This guide walks through coffee shop construction from budgeting to opening day, with a North Texas and DFW lens. Pilot Painting & Construction, a family-run commercial contractor based in Pilot Point, works with businesses across the DFW area on tenant improvements, whitebox remodels, and renovations — the kind of groundwork a café buildout needs.
Key Takeaways
- Space condition (cold shell vs. second-generation café) drives your budget more than any other single factor
- Layout must serve both back-of-house workflow and front-of-house customer flow
- Permits, health codes, and ADA compliance aren't optional — plan for them early
- A contractor experienced in commercial food-service buildouts prevents costly rework
Understanding Coffee Shop Construction Costs and Budgeting
Your biggest cost driver isn't finishes or furniture. It's the condition of the space you lease. That condition usually falls into one of three categories:
- Cold shell: No electrical, plumbing, or HVAC in place — you're building from scratch
- Second-generation café: Previous tenant left usable equipment hookups and layout
- Standard commercial shell: Base utilities in place, but no food-service infrastructure
RSMeans' national restaurant model estimates construction subtotals of $149–$164 per square foot. Add a 25% contractor fee and 7% architectural fee, and total building costs land near $199–$220 per square foot.
That figure is a restaurant-building proxy, not a coffee-shop quote. It still shows why a headline number rarely tells the full story.
What Does a Full Buildout Actually Cost?
A RestaurantOwner survey (year unspecified) reports total restaurant startup costs across three tiers:

| Tier | Total startup cost |
|---|---|
| Lower quartile | $175,500 |
| Median | $375,500 |
| Upper quartile | $750,500 |
Construction alone ranges from $70,000 to $472,500 depending on scope. Kitchen and bar equipment adds another $40,000 to $196,250.

These are restaurant figures, not coffee-specific ones. They're still the closest sourced benchmark available, and coffee shops typically land toward the lower end given smaller footprints.
Major cost categories to budget for:
- Permits and licenses (health, building, fire, signage)
- Labor and construction subcontractors
- Kitchen and espresso equipment
- FF&E (furniture, fixtures, equipment)
- Contingency fund for surprises
Can You Open a Coffee Shop for $50,000?
Not a conventional full café. The survey's lower-quartile construction figure alone is $70,000 — already above a $50K total budget. A $50K budget realistically supports:
- A small kiosk or cart-style concept
- A project where the landlord contributes significant buildout costs
- A space with existing café infrastructure requiring minimal work
Trade-offs at this budget level usually mean limited seating, simplified menu equipment, and minimal build scope.
Soft Costs vs. Hard Costs
Both need line items in your budget:
- Soft costs: Design, architecture, permitting, engineering
- Hard costs: Construction labor, materials, equipment installation
Skipping soft-cost budgeting is a common first-time-owner mistake. Design and permitting fees can add 10-15% on top of construction costs alone.
A contractor experienced in restaurant tenant improvements, such as Pilot Painting & Construction, can help set realistic expectations before you sign a lease, not after you discover the space needs a new electrical panel.
Designing an Efficient and Inviting Coffee Shop Layout
Your layout has one job: move people and drinks efficiently while feeling welcoming enough that customers linger.
Quick-Service vs. Full-Service Design
- Quick-service: Prioritize counter space, queue management, and grab-and-go efficiency
- Full-service: Give more square footage to lounge seating, work-friendly tables, and slower customer flow
Quick-service formats also tend to need less back-of-house depth, since the menu is typically simpler.
Key Functional Zones

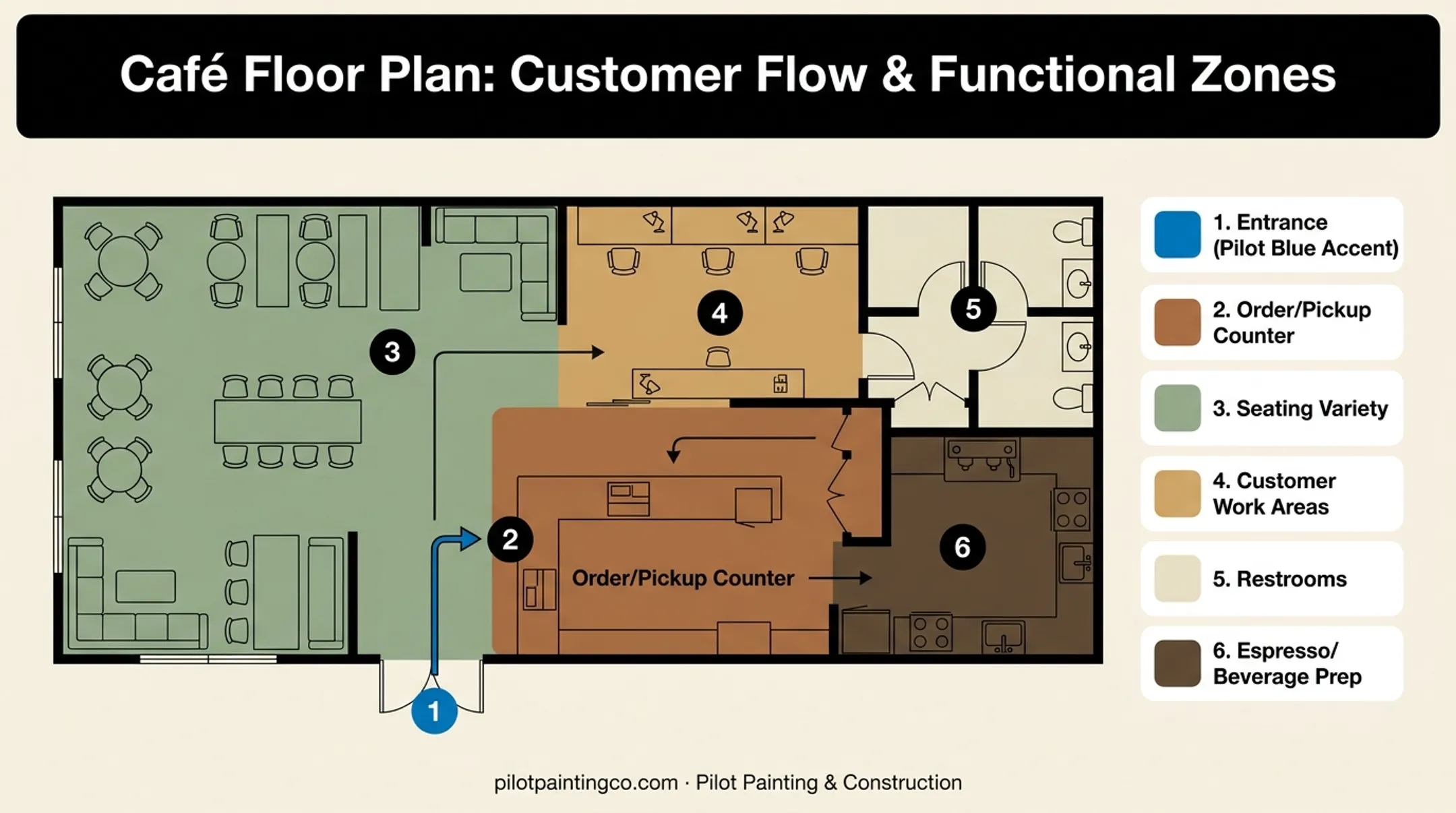

Every café layout needs these zones mapped before construction begins:
- Order and pickup counter — highest-traffic point; design queue paths so they never cross the seating floor
- Seating variety — mix communal tables, two-tops, and lounge chairs to support different dwell times
- Customer work areas — counter seats with outlets and stable Wi-Fi for laptop customers
- Restrooms — place for access and privacy; build to current ADA standards
- Espresso and beverage prep — needs dedicated plumbing, drainage, and high-load electrical from day one

Interior Design That Reinforces Your Brand
Color, lighting layers, furniture, and acoustics tell customers what kind of café you run. Bright minimal finishes read fast and modern; warm wood and softer light encourage longer stays.
Infrastructure to assess early, before design finalizes:
- HVAC capacity for the space and equipment heat load
- Electrical capacity — a two-group La Marzocco Linea PB espresso machine alone draws 4,600W on 220V single-phase power, and a four-group unit draws up to 8,000W
- Plumbing for beverage prep, handwashing, and health code compliance
Hand your full equipment list to the electrical and mechanical engineers before design lock-in. Adding circuits and plumbing after walls are closed is one of the costliest buildout mistakes.
Navigating Permits, Codes, and Compliance
Coffee shop construction touches more regulatory bodies than most business owners expect.
Core permits typically required:
- Building permit
- Health department (retail food establishment) permit
- Fire safety permit
- Plumbing and electrical permits
- Signage permit
Fees vary significantly by city. Texas DSHS lists retail food permit fees at $258, $515, or $773 depending on gross annual sales. Dallas separately charges a $121 food-establishment application fee plus a $205 plan-review fee, with additional annual fees based on risk level and square footage.
Fort Worth routes larger remodels through its own plan review process. Confirm which office issues which fee before you assume one number covers everything.
ADA Compliance Can't Be an Afterthought

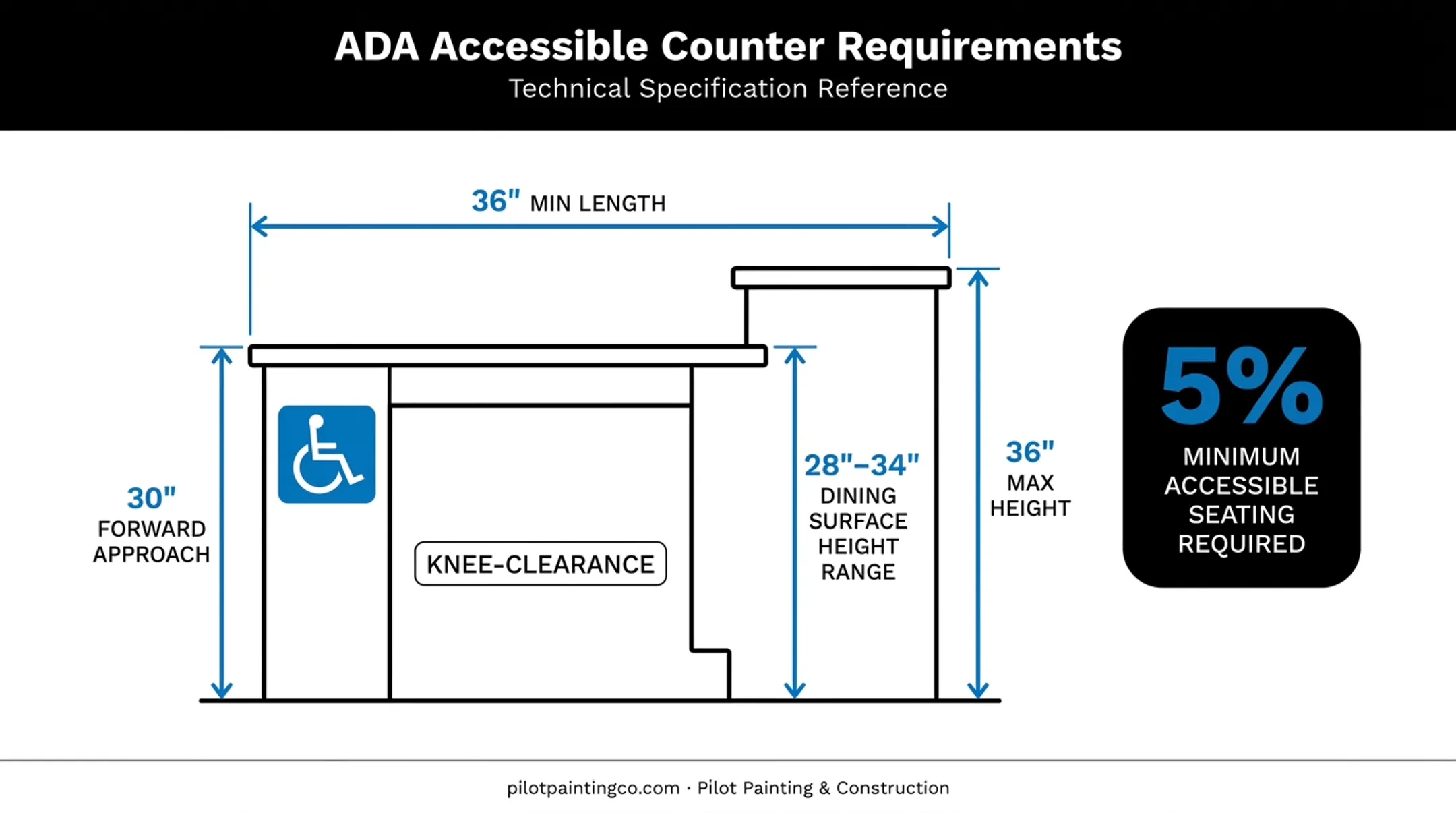

The 2010 ADA Standards require an accessible route to every dining area, including outdoor seating. Specific measurements matter:
- Accessible counter portions: minimum 36 inches long, maximum 36 inches high (or a forward-approach alternative at 30 inches minimum length with knee clearance)
- Dining surface heights: 28-34 inches above the floor
- At least 5% of seating must comply with accessible-dining-surface rules

Retrofitting a counter after construction is far more expensive than designing it correctly the first time.
Compliance tips that save headaches:
- Verify zoning allows food-service use before signing a lease
- Schedule pre-inspection walkthroughs with local health and building officials
- Consult local authorities early — Dallas, Fort Worth, and smaller North Texas municipalities each handle permitting differently
Bring in a contractor who already works North Texas codes and health-department expectations before plans go in—so you fix conflicts once, not after a rejected submittal.
Building Your Construction Team and Timeline
You need more than a general contractor. Food-service buildouts need:
- An architect familiar with restaurant/café layouts
- A kitchen equipment consultant
- Lighting and acoustics specialists (for larger, full-service concepts)
- A contractor who's coordinated health department inspections before
Realistic Timeline Expectations

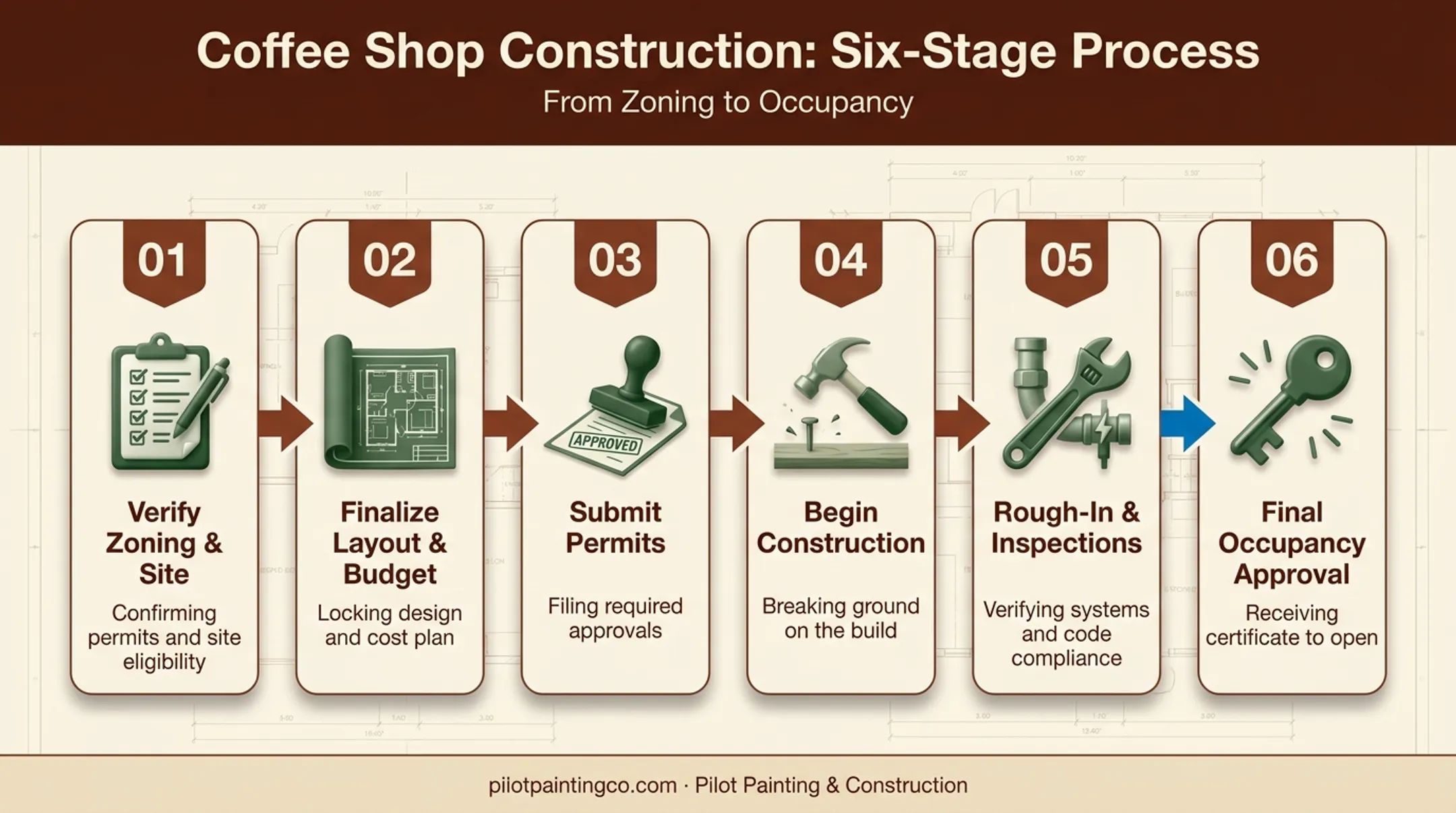

There's no single verified industry-wide timeline for coffee shop construction. Plan the build in clear phases instead:
- Verify zoning, occupancy, and site conditions
- Finalize layout, equipment schedule, and budget
- Submit permits (health, building, trade, fire, signage)
- Begin construction once critical permits and long-lead equipment are confirmed
- Complete rough-in work and inspections before finishes
- Secure final occupancy and health department approval

Add schedule buffer for permit review delays and equipment lead times. Those two factors cause most missed opening dates.
Pilot Painting & Construction brings commercial experience in tenant improvements and whitebox remodeling, so the team knows how these phases depend on each other. Clear communication through the full project, not only at estimate, helps DFW-area owners avoid the miscommunication gaps that derail first-time buildouts.
Choosing the Right Contractor for Your Coffee Shop
Not every commercial contractor understands food-service-specific requirements. A contractor experienced with health-department-regulated buildouts knows to:
- Coordinate directly with health inspectors, not just building inspectors
- Anticipate ADA counter and restroom requirements before framing begins
- Sequence electrical and plumbing rough-ins around equipment specs
Look for a contractor who communicates proactively. The right partner flags issues before they become change orders and coordinates with your architect and consultants, instead of leaving you to manage the gaps yourself.
Pilot Painting & Construction works with restaurants and commercial clients across Pilot Point and the DFW area on tenant improvements, whitebox remodeling, drywall, flooring, concrete, and commercial painting. Clear communication is built into how the team runs café and restaurant buildouts, so coordination stays tight from rough-in through finish. Call 940-286-3838 to discuss a project.
Frequently Asked Questions
How much would it cost to build a coffee shop?
Costs vary widely by space condition and format. Restaurant startup surveys put total buildout ranges roughly between $175,500 and $750,500. Always include a contingency fund; construction surprises are the norm, not the exception.
Can I open a coffee shop with $50k?
A $50,000 budget is below typical lower-quartile construction costs for restaurant buildouts, so a full café is unlikely. It's more realistic for a small kiosk or cart concept, or a space where the landlord covers significant improvements.
What do you need to build a coffee shop?
You need a location, budget or financing, a design plan, permits (health, building, fire, signage), a construction team, and equipment. Skipping any one of these usually causes delays later.
How long does it take to open a coffee shop?
Timelines hinge on shell condition, permit review speed, and equipment lead times. Permitting and inspections are usually the longest phases to plan around.
What permits do I need to open a coffee shop?
Core permits include building, health department, fire safety, plumbing/electrical, and signage. Costs vary by city. Texas health permits alone range from $258 to $773 depending on sales volume, and Dallas charges separate application and plan-review fees.
